Complete the substation 4 weeks after gear arrival. The electrical equipment was delayed in manufacturing by the gear manufacturer, and the general contractor needed to turn the project over to GM within 6 weeks of receiving gear.
Solution

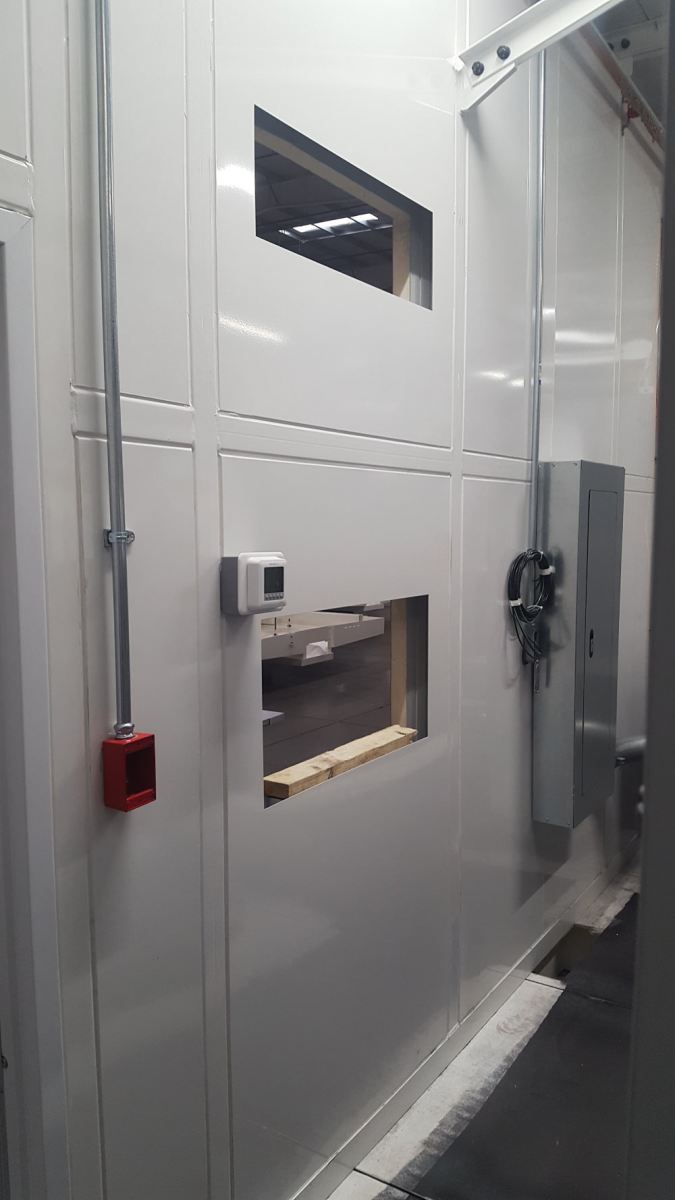

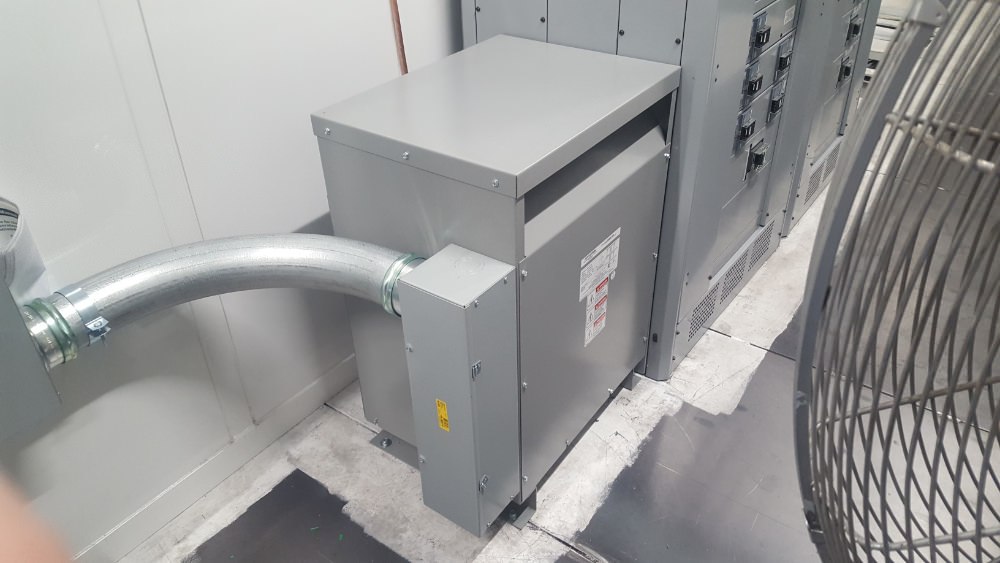

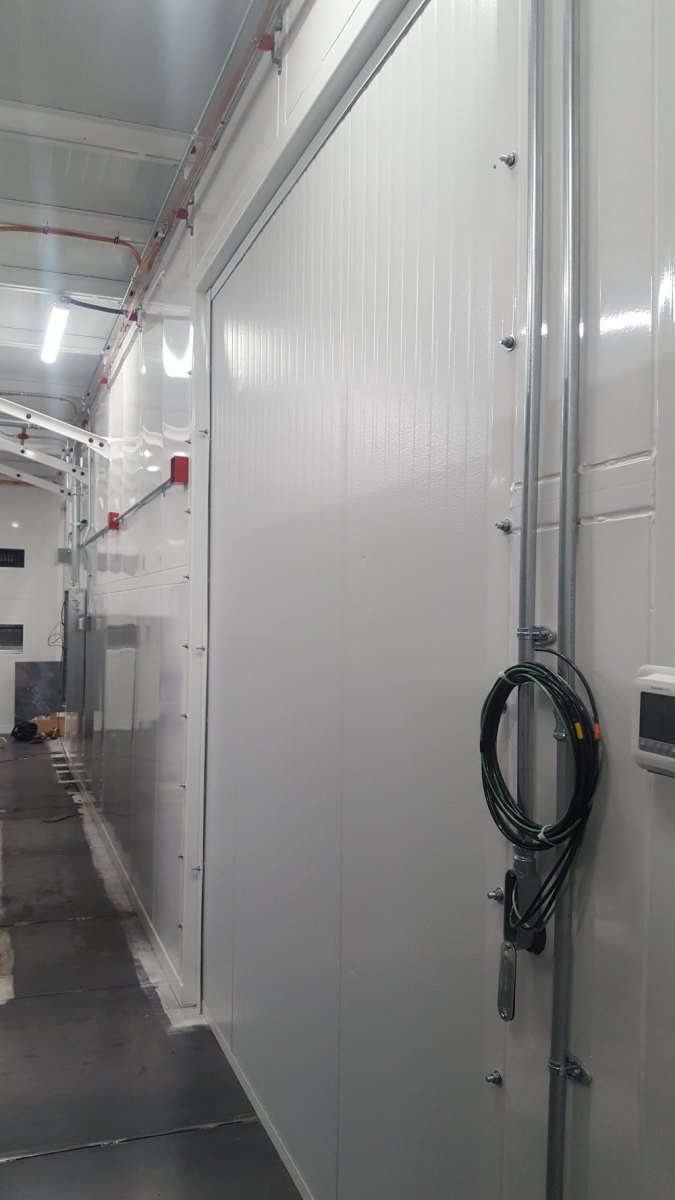

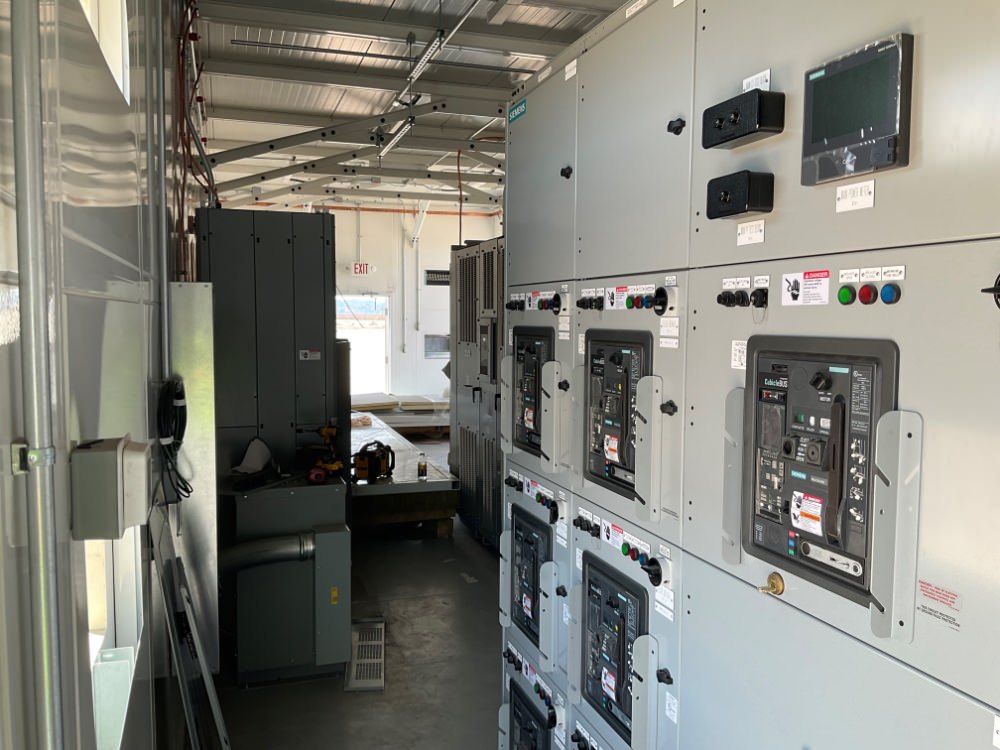

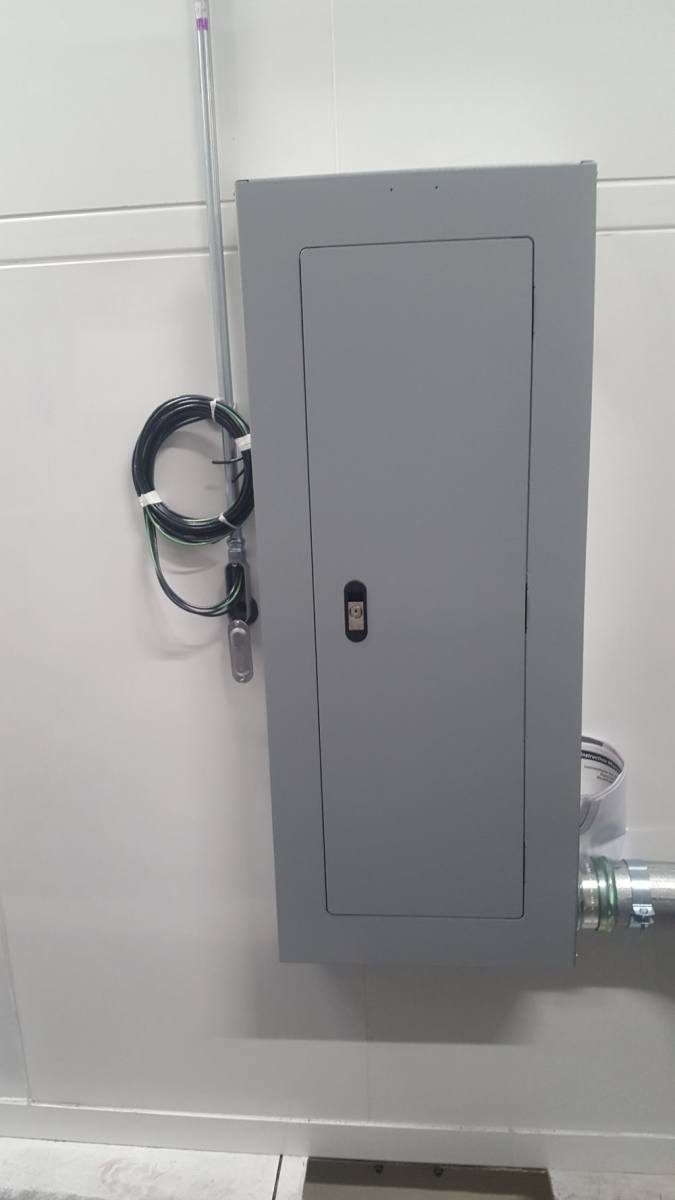

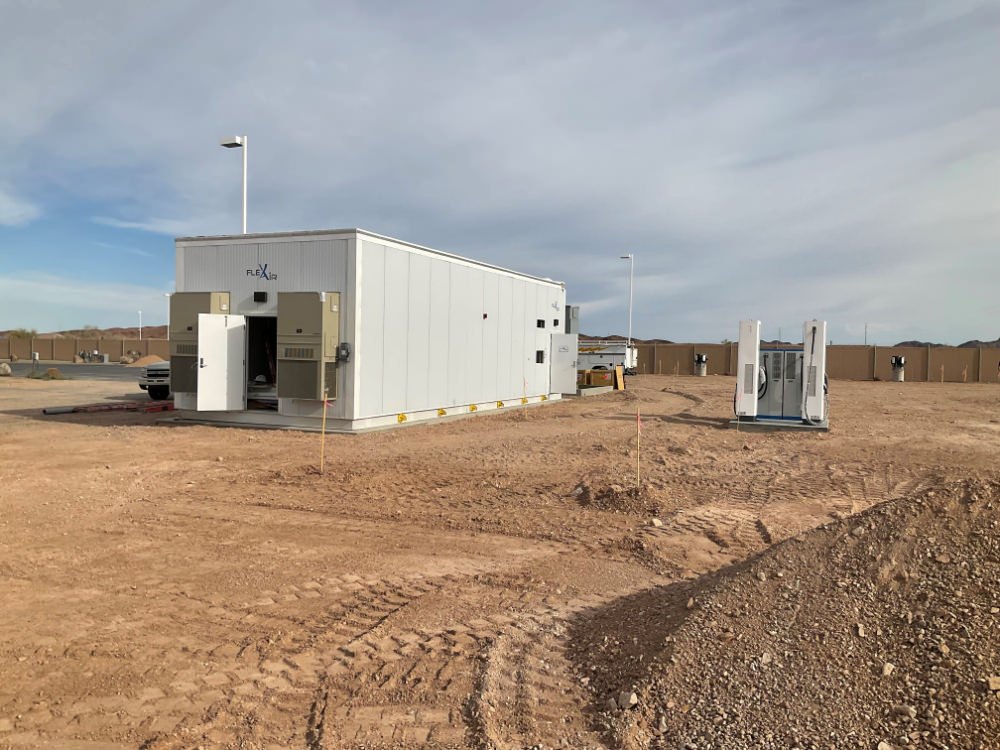

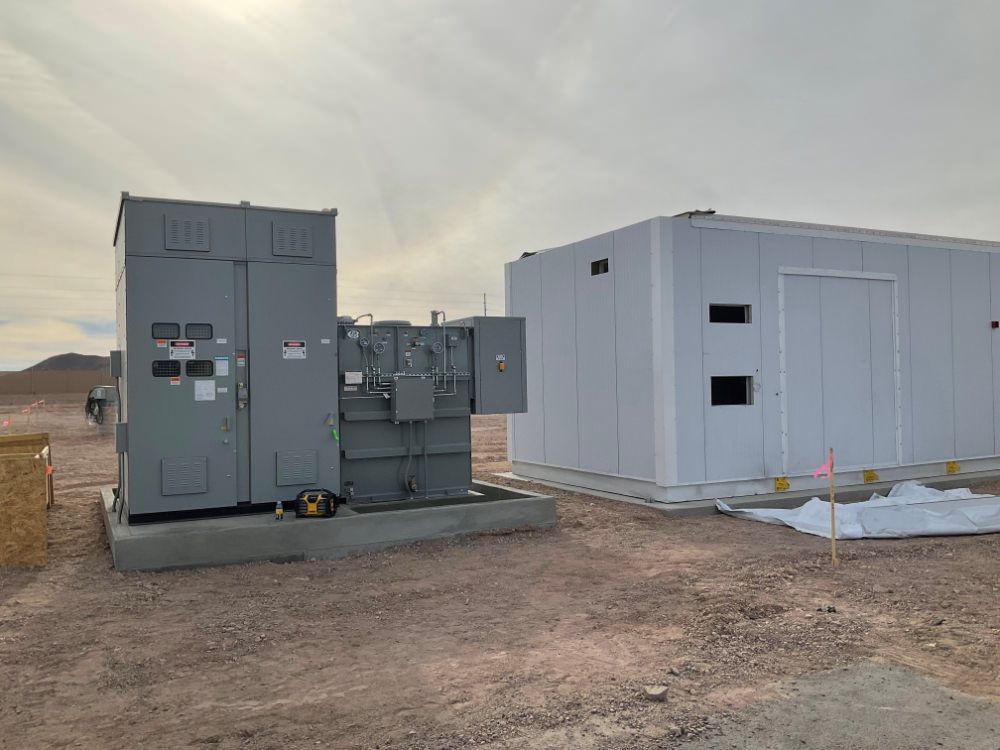

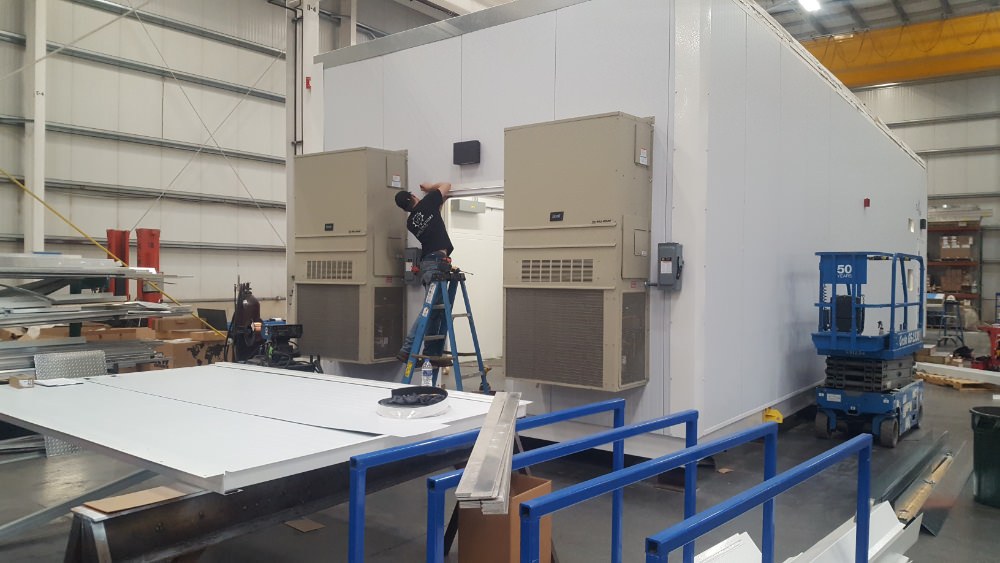

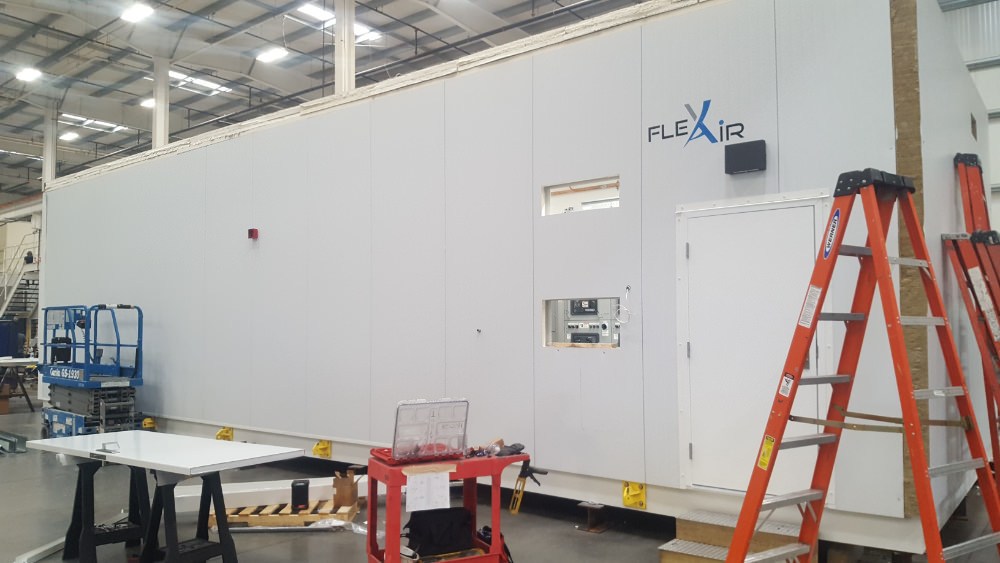

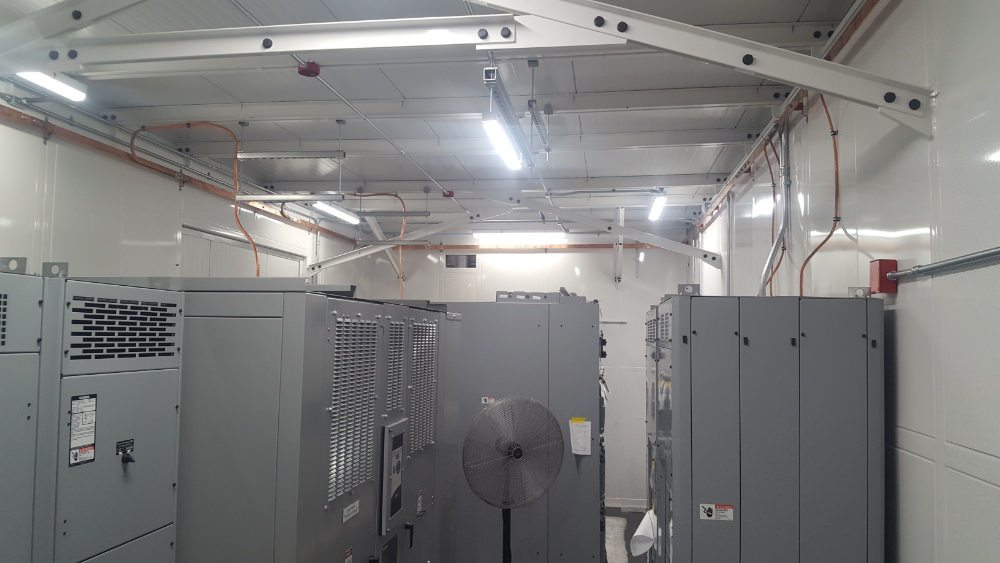

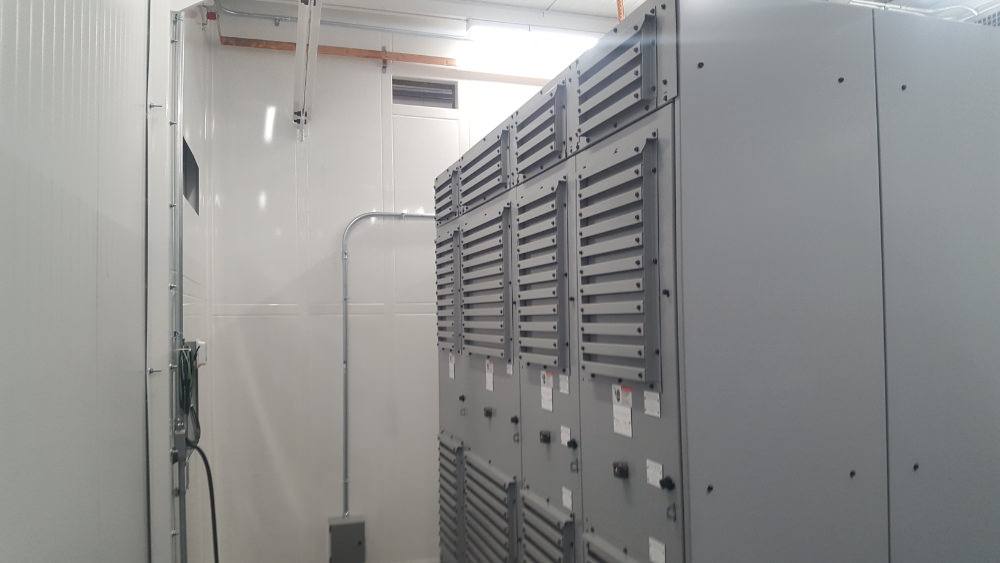

⦁ Flex Air designed and engineered a modular enclosure for the gear. ⦁ The enclosure was ready on the manufacturing floor when the gear arrived. ⦁ Shipped a “turnkey” unit within 4 weeks of receiving gear.
